MOCCAE pet import permit for dogs from the UK (2026)

    What MOCCAE requires — sequenced, timed and easy to verify.

    Last reviewed

    One mistake can stop your dog being loaded onto the aircraft. If the problem isn't caught until after landing, it can mean quarantine or being sent back to the UK at your expense.

    The frustrating part is that the paperwork can look correct and still fail. With MOCCAE, order and timing matter as much as the documents themselves. A vaccine given too early, one wrong microchip digit, or an expired certificate can be enough.

    This guide explains the checks that matter. I've flown my own dog, Kio, into the UAE. The free dog travel planner uses your dog's breed, age, weight and travel month to show you what applies, so you're not piecing it together from scratch.

    Get my dog's travel plan

    UK to UAE dog travel planner · Free · No signup

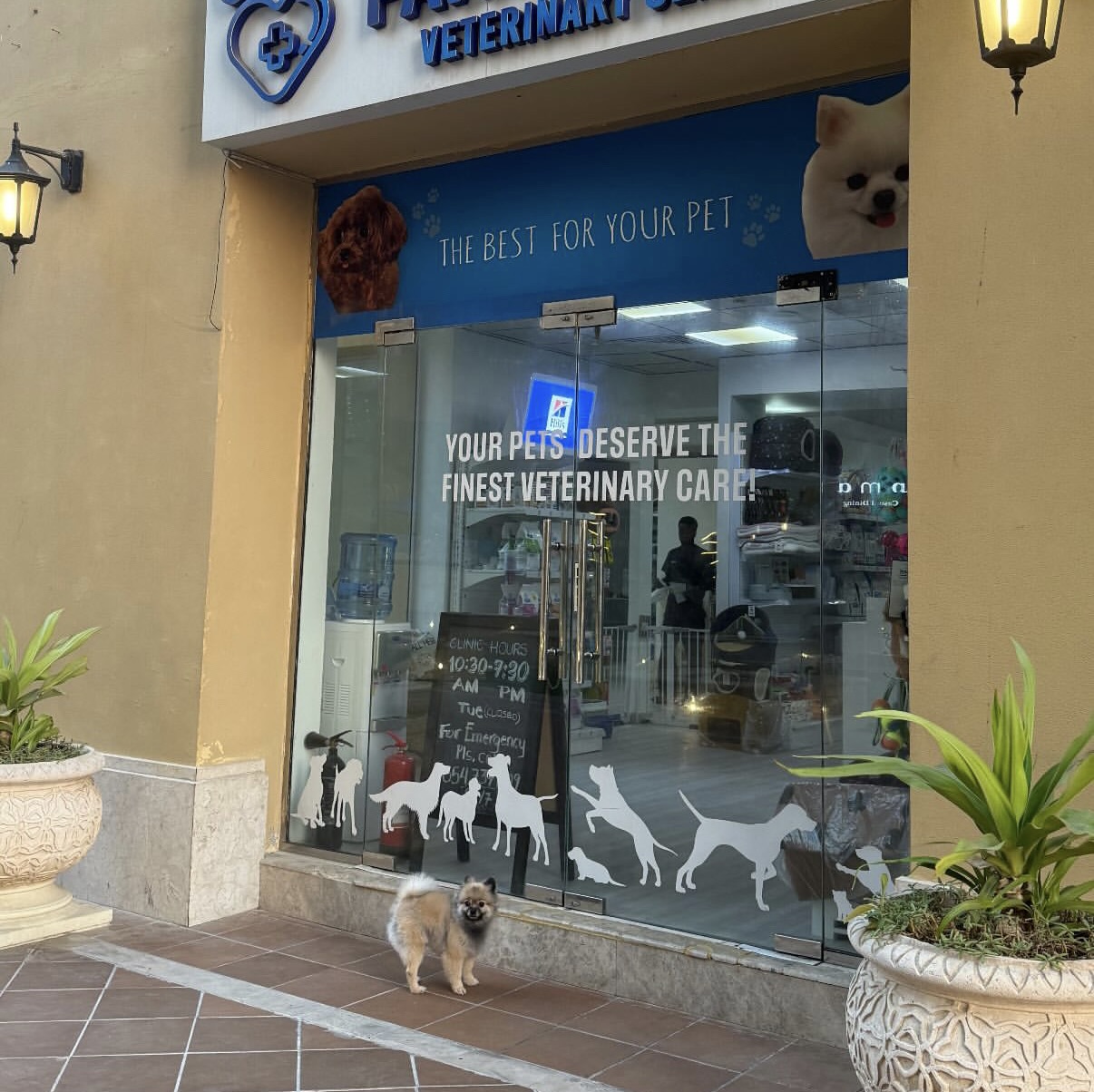

    Kio, a Pomeranian, at a UAE veterinary clinic.
    Kio at the vet — where the microchip number and vaccination records are checked against what MOCCAE will see on arrival.

    The rules that decide whether your dog can travel

    In 2026, dog imports are controlled by the UAE Ministry of Climate Change and Environment (MOCCAE), working with UK export authorities including the Animal and Plant Health Agency (APHA).

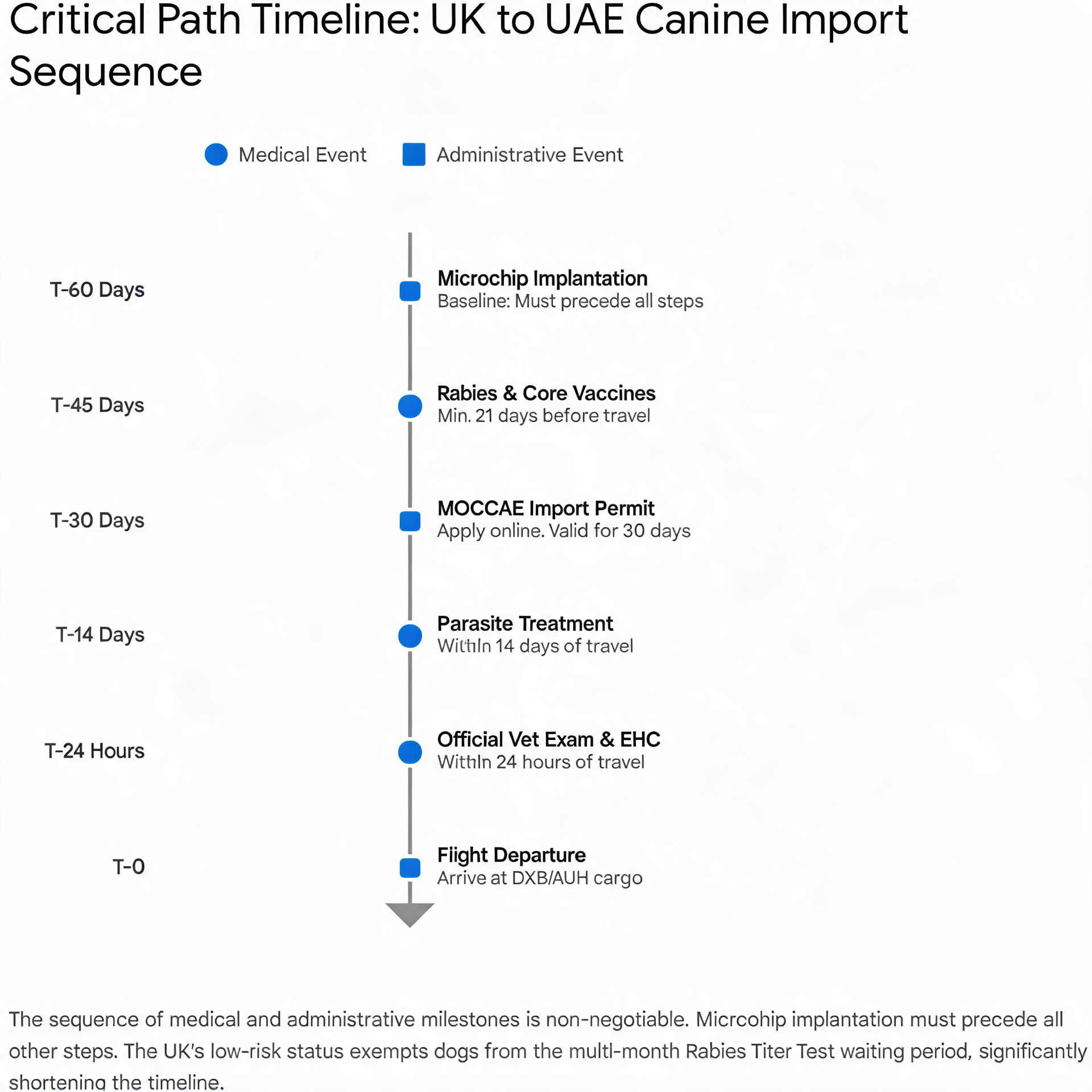

    For a compliant UK import, the key sequence is:

    • An ISO 11784/11785 microchip must come before vaccination.
    • Rabies vaccination must be followed by the 21-day wait.
    • The MOCCAE import permit has 90-day validity.
    • APHA EHC 3926 is issued the day before the dog flies.
    • Most dogs enter as cargo through DXB or AUH.

    Get the sequence right and a dog arriving from the UK is usually released at the cargo facility without quarantine. Get it wrong and border staff are unlikely to fix it for you.

    Start with the dog's legal identity

    The microchip is the identity that ties the whole file together. It must be ISO-compliant under ISO 11784/11785 and have a 15-digit unique identifier.

    It must be implanted before any rabies or travel vaccination. If the vaccine came first, UAE rules treat that record as invalid. The number must also match every vaccination record and health certificate exactly.

    That sounds simple. It is also an easy way for an otherwise healthy dog to be refused.

    Rabies timing is unforgiving

    The rabies vaccination must be administered at least 21 days before travel and must remain valid when the dog enters the UAE.

    An overdue booster is treated as a new primary vaccination. That restarts the 21-day countdown.

    Dogs also need recorded vaccination against Canine Distemper Virus, Canine Parvovirus, Canine Infectious Hepatitis (Adenovirus), and Leptospirosis. The UK pet passport or vaccination booklet must be signed and stamped by a licensed vet. Manufacturer stickers and batch numbers must be present.

    For dogs exported directly from the UK, an RNATT is not required. The UK is classed as a rabies-controlled country. A transit through a high-risk country can change that, so if you're not flying direct, confirm your routing with my recommended pet relocation company before you book.

    Contact my pet relocation company →

    The MOCCAE permit has a 90-day window

    The MOCCAE import permit is the UAE government's approval for your dog to enter. Without it, the airline will not accept the dog.

    The permit is valid for 90 days from issuance. Your dog must physically enter the UAE before it expires.

    You may still see a 30-day period in older guidance, including older wording on MOCCAE's public-facing service page. MOCCAE has confirmed directly by email that the current validity is 90 days from issuance.

    My recommended pet relocation company can prepare and submit the application. It uses the dog's microchip certificate and vaccination history, plus your passport copy and travel details. The government fee is typically around AED 200 per dog.

    Contact my pet relocation company →

    APHA EHC 3926 is the final timing trap

    The UK export document is Export Health Certificate EHC 3926. It must be issued by an Official Veterinarian approved by APHA.

    The Official Veterinarian examines your dog and issues the UK Export Health Certificate the day before the dog flies. Your Official Veterinarian or my recommended pet relocation company should arrange the appointment for that day.

    Some airlines ask for your dog's documents a few days before the flight, before the EHC can be issued. My recommended pet relocation company handles this, usually by sending the airline a fit-to-fly certificate and your dog's flea and worming record in advance.

    Contact my pet relocation company →

    Before certification, the vet checks that the microchip is readable and matches the records. The dog must show no signs of infectious disease. Parasite treatment for fleas, ticks, and tapeworm must have been given within 10 days of travel.

    Your UK vet must issue a Fitness-to-Fly Certificate within 10 days of the flight. Most airlines require this vet-signed certificate in addition to the EHC, confirming your dog is healthy enough for cargo travel.

    This is why a generic checklist is not enough. Dates that work for one dog may fail for another.

    Breed rules can end the journey before it starts

    Under EHC 3926, the following breeds and their crosses are refused entry to the UAE:

    • Pit Bull Terrier, American Pit Bull Terrier
    • Staffordshire Bull Terrier, American Staffordshire Terrier, American Bully
    • Japanese Tosa, Dogo Argentino, Fila Brasileiro
    • Tibetan Mastiff, Neapolitan Mastiff, French Mastiff (Dogue de Bordeaux), Bullmastiff
    • Boerboel, Cane Corso, Presa Canario, Bully Kutta

    Assessment can be based on physical characteristics. A mixed-breed dog that resembles one of these breeds may also be refused. Staffordshire Bull Terrier and Bullmastiff owners are often caught out by this.

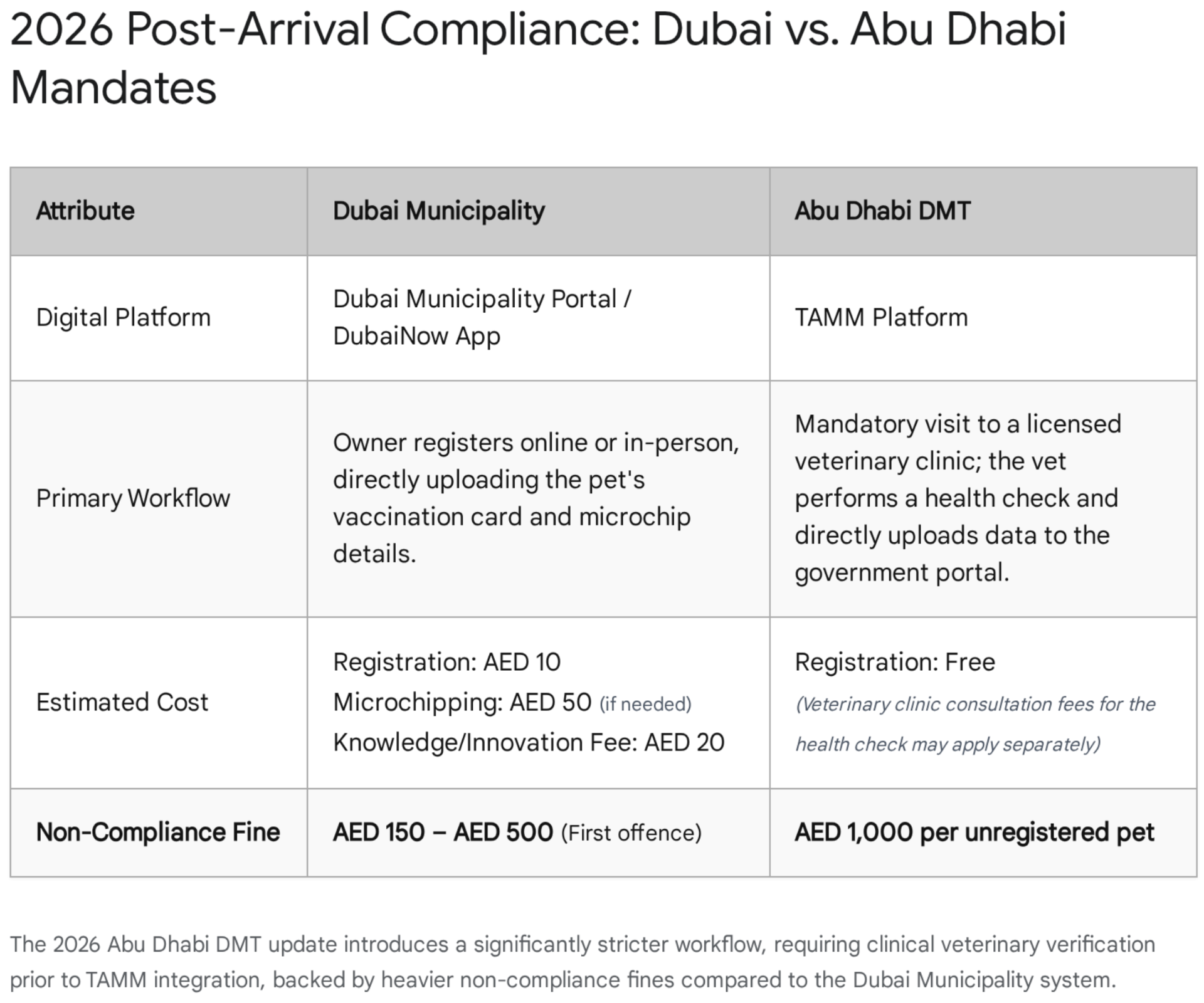

    Import permission is not the same as permission to keep a dog without local conditions. Dubai and Abu Dhabi both follow federal MOCCAE import rules, but their post-arrival registration requirements differ — those are covered in the How to move a dog from the UK to the UAE in 2026 (step-by-step guide).

    If breed eligibility is the uncertainty, resolve it before you go further — my recommended pet relocation company can confirm it against your dog's specific breed mix.

    Contact my pet relocation company →

    Most dogs arrive as cargo

    Most dogs from the UK travel as cargo, under a cargo airway bill, in a ventilated approved crate, through the live animal facilities at DXB or AUH. Only Etihad to Abu Dhabi allows dogs in the cabin from the UK, at 8 kg or less including the carrier, subject to breed restrictions and airline approval.

    I spoke with each vet directly before recommending them.

    My recommended Official Vet handles your dog's Export Health Certificate and vaccinations, and comes to your home anywhere in London. Furs Class Travel families also get a free fit-to-fly.

    Contact my UK vet →

    My recommended import vet handles your dog's import permit and arrival into Abu Dhabi or Dubai. Furs Class Travel families also get a free arrival health check.

    Contact my UAE vet →

    Free · Opens an email ready to send · Reply within 1 working day

    On arrival, staff scan the microchip and check the original documents. A government veterinarian inspects the dog before customs clearance. If everything matches, the dog is released directly to the owner. There is no automatic quarantine for a compliant UK import.

    The errors that cause refusals

    Most failures are not about the dog's health. They come from a vaccine recorded before the microchip, less than 21 days between rabies vaccination and travel, or a mismatch in the documents. Missing signatures can stop clearance. So can an EHC not issued the day before the dog flies, or parasite treatment outside the 10-day window before travel.

    Breed classification and travel routing can also change the answer. Those are the variables a general guide can't settle for your dog.

    Get the rules for your dog

    You do not need to turn yourself into an import specialist. You need the steps in the right order for your dog.

    Use the free dog travel planner. It uses your dog's breed, age, weight and travel month to show you what applies, in the right order — and who I'd trust to help with the rest.

    Frequently asked questions

    How long is the MOCCAE import permit valid in 2026?

    It is valid for 90 days from issuance. Your dog must enter the UAE before it expires. Older guidance may still say 30 days.

    Do dogs travelling directly from the UK need an RNATT?

    No. The UK is classed as a rabies-controlled country, so dogs flying directly don't need one. A transit through a high-risk country can change that — check your routing with my recommended pet relocation company if your flight isn't direct.

    When must the rabies vaccination be given?

    At least 21 days before travel, and it must still be valid when your dog enters the UAE.

    When is APHA EHC 3926 issued?

    The UK Export Health Certificate (EHC 3926) is issued by an APHA-authorised Official Veterinarian the day before the dog flies. Arrange the appointment with your Official Veterinarian or my recommended pet relocation company for that day.

    Can my dog fly in the cabin?

    Only Etihad to Abu Dhabi allows dogs in the cabin from the UK, at 8 kg or less including the carrier, subject to breed restrictions and airline approval. Most dogs travel as cargo through DXB or AUH.

    Do I need an Emirates ID to import my dog?

    No. You can apply for the MOCCAE import permit with your passport, and you'll indicate that the move is permanent during the process. You don't need to wait for your Emirates ID before your dog travels.
